Gas Line Replacement Project

On this page:

About the Project

The gas line replacement project on the Dayton campus is scheduled to take place from November 2024 to August 2025. During this time, there will be excavation, boring, and other types of construction work occurring at various locations.



Schedule of Shutdown for the Phases

Vault Installations

  • Location 1: University Hall - 12/09/24 to 12/20/24
  • Location 2: Mathematical and Microbiological Sciences Building - 12/09/24 to 12/20/24
  • Location 3: Medical Sciences Building - 12/09/24 to 12/20/24
  • Location 4: Brehm Laboratory/Oelman Hall - 12/09/24 to 01/01/25
  • Location 5: Russ Engineering Center - 01/01/25 to 04/01/25


Timeline

Phase #1
Task Status Start Date End Date
Layout Phase 1 vaults  circle-half-stroke In Progress 11/02/24 11/25/24
Installation of Phase 1 Mainline circle-notch Not Started 01/06/25 02/10/25



Phase #2
Task Status Start Date End Date
Layout Phase 2 Dog Park to campus circle-notch Not Started 11/02/24 11/25/24
Installation of Phase 2 Mainline  circle-notch Not Started 02/01/25 03/20/25



Phase #3
Task Status Start Date End Date
Layout Phase 3 Dog Park to Student Union circle-notch Not Started 12/20/24 01/01/25
Installation of Phase 3 Mainline circle-notch Not Started 02/10/25 04/01/25



Phase #4
Task Status Start Date End Date
Layout Phase 4 Student Union to toward Colonel Glenn Hwy. to Fawcett Hall circle-notch Not Started 02/23/25 03/01/25
Installation of Phase 4 Mainline circle-notch Not Started 03/01/25 05/02/25



Phase #5
Task Status Start Date End Date
Layout Phase 5  Fawcett Hall to Dog Park  circle-notch Not Started 02/28/25 03/15/25
Installation of Phase 5 Mainline circle-notch Not Started 03/15/25 06/01/25


Maps of Locations and Zones

Download the gas line replacement map (PDF)

Download the map of new gas vault locations (PDF)

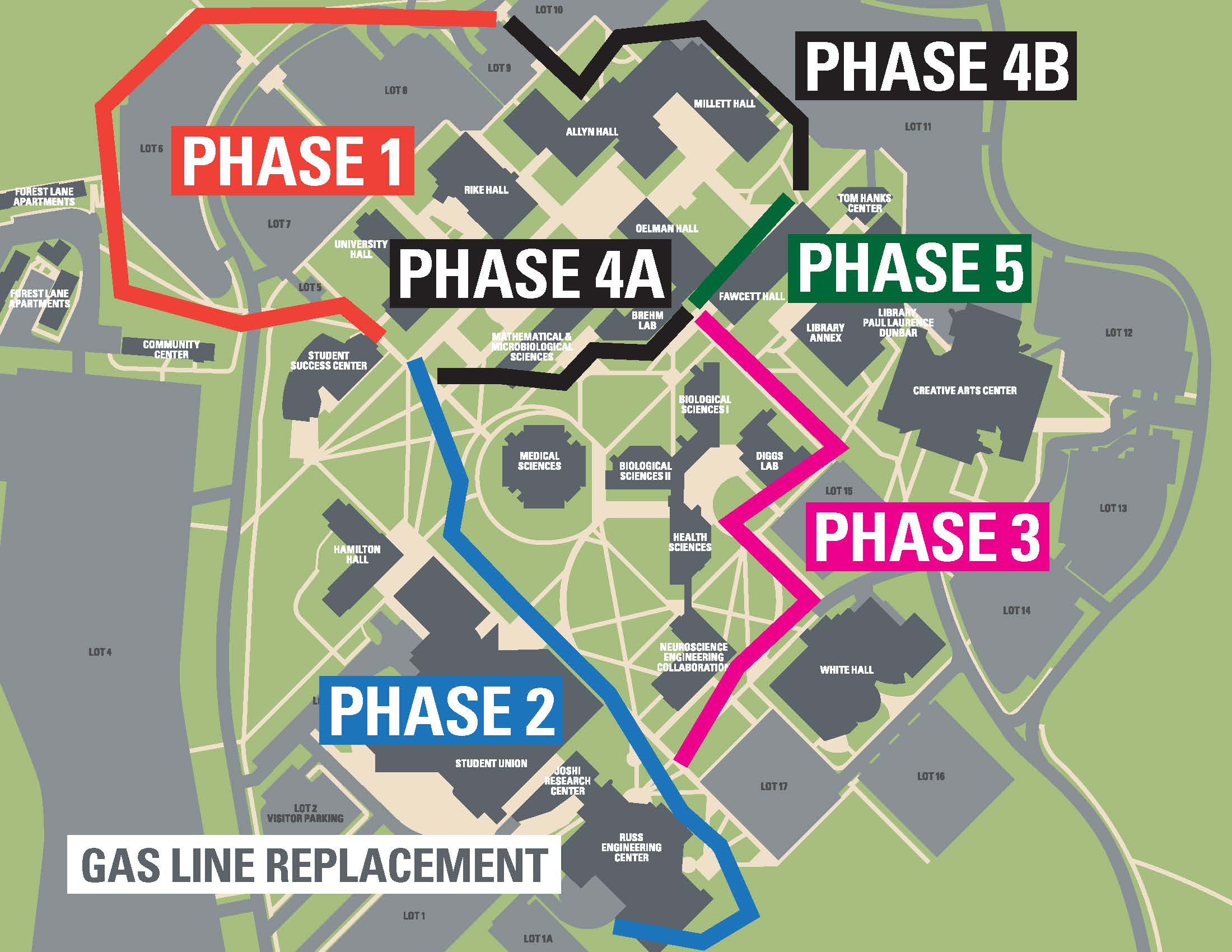

Gas Line Replacement Map

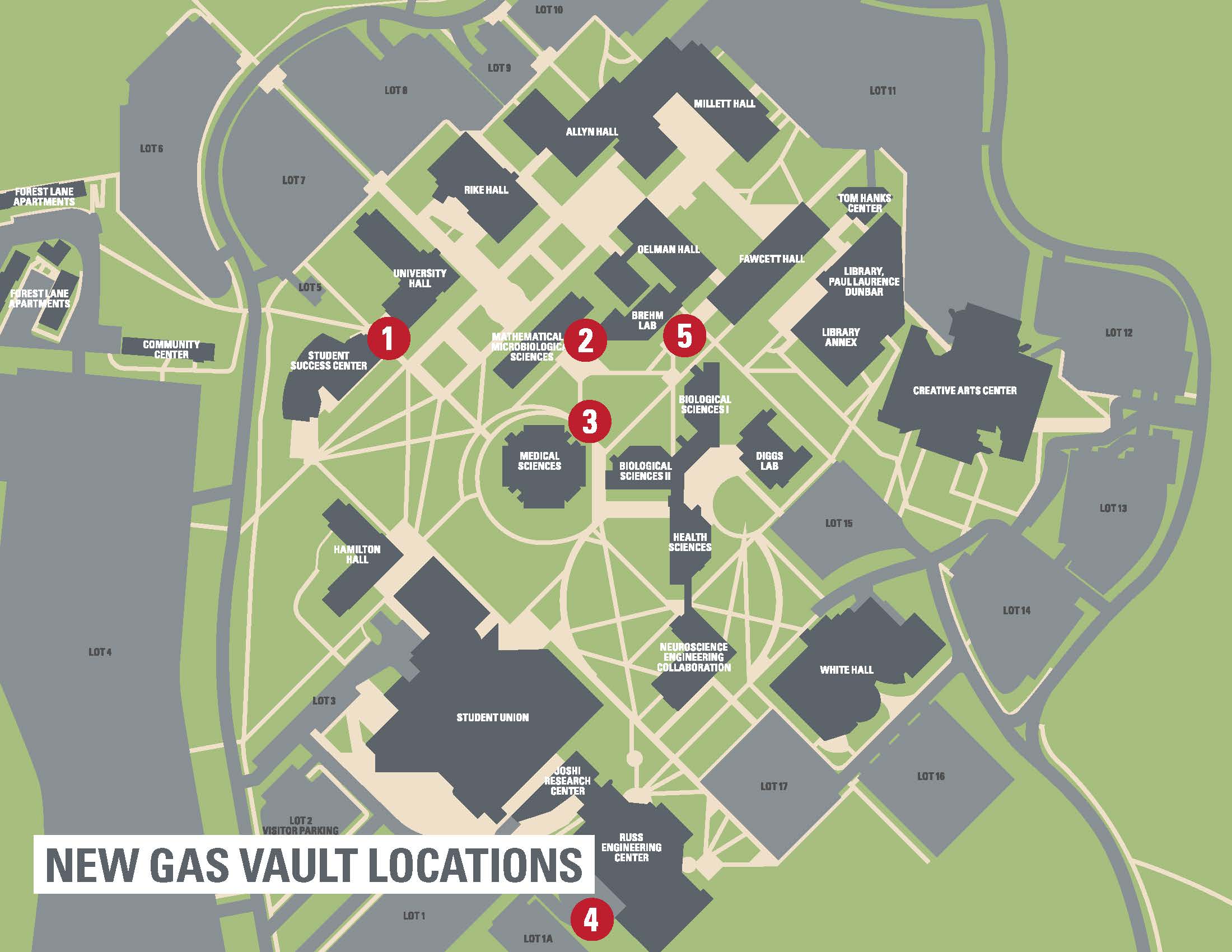

New Gas Vault Locations
